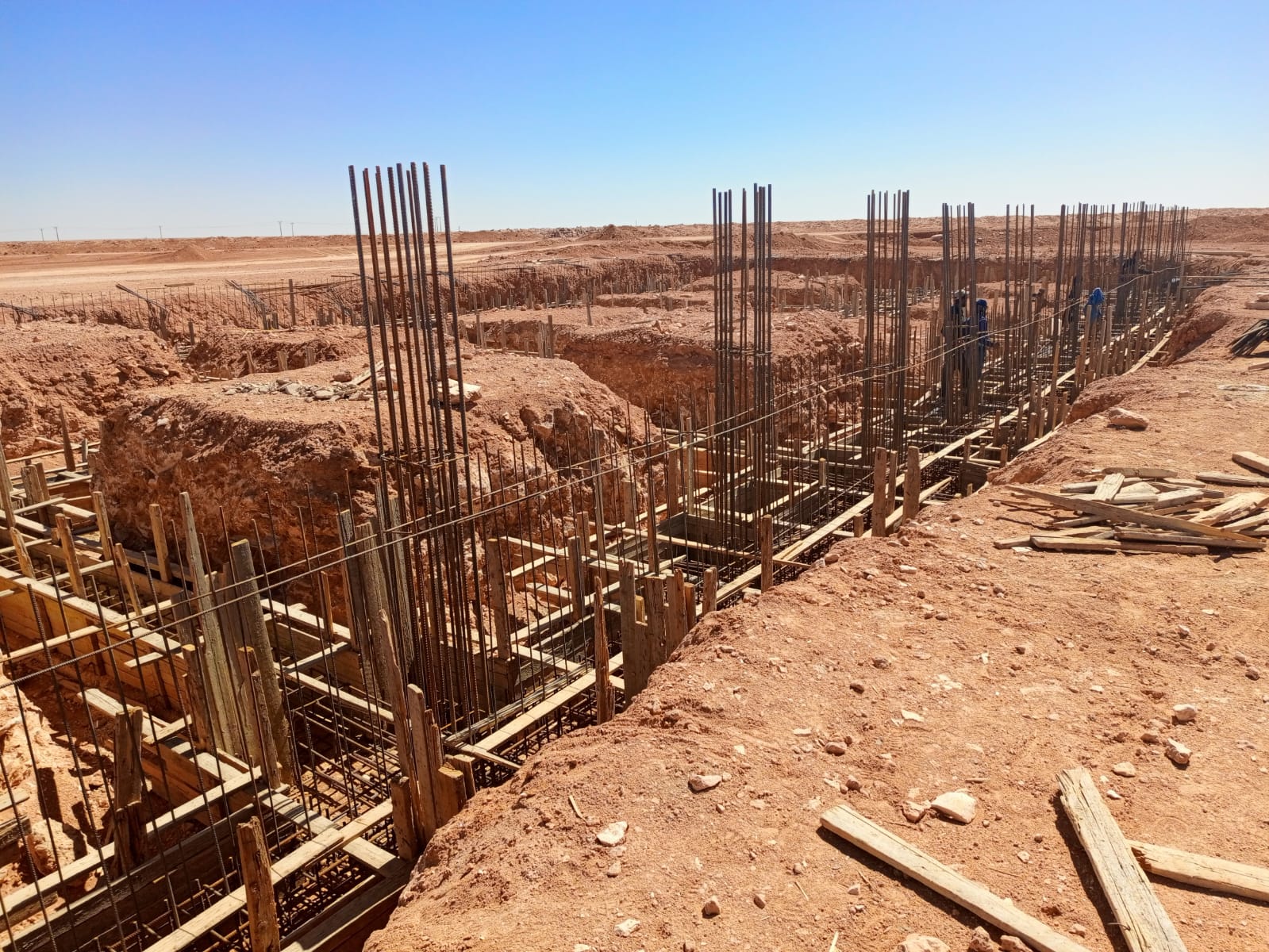

The implementation of civil works has been started for the establishment of the Risha S.S.
400/132/33 kV, as part of the cooperative efforts with brotherly Iraq in the field of electrical interconnection, which strengthens the brotherly relations between the two countries.
works are applied by the contractor (Ismail Establishment for Contracting and General Maintenance).
The project is one of the American grant projects and consists of the control building, the capacitor building in addition to buildings within the yard of electrical equipment breakers and the service building in addition to the yards of electrical equipment and the usual construction requirements for this type of stations.
The project work was started on 22.
January of this year and is expected to be completed within 12 months as maximum with value of the assignment of 3365487.58 JD.
Al-Aqsa as the value of the referral
